Road Conditions


Date: 15 September-2021 (06:33 AM)

Road sitrep- 15/09/2021

Pakyong Sub-Division

1.Assam pakyong road closed at km 8th ch2nd to ch 5th due to massive slide occurred on 21st August. 150m length of road washed out . Joint inspection with L&R DEPTT , public, panchayat, & MLA done on 7th September 2021 and it was decided to start the restoration works after 20th September 2021 when the monsoon subside .

2.Other roads are open.

Singtam Sub-Division

1.All roads under singtam sub division is clear and open for traffic .

Mangan Sub-Division

1.Phidang Sangtok road blocked.

2.All other roads open except FWRs.

Soreng Sub-division

1.Soreng kaluk road at Km 10th is trafficable for LMV only .

2.Rest all roads are trafficable for all types of vehicular movement

3.All FWRs are blocked due to slips

Namchi Sub-divison.

1. Namchi-phongla-Mamring road is Open for all types of vehicle. One way traffic is only possible at few of the locations, due to slip

2. Namchi to Vok is Open for LMV only.

3. Namchi to Rong-Sumbuk is Open.

4. Namchi to CCCT fatak via Assangthang is Open.

5. Namchi to Perbing via Upper Ghurpisey is Open.

6. Namchi Byepass road is Open for LMV only.

7. Phongla to Chuba Perbing road is Open for LMV only.

8. Phongla to Bermiok road is blocked at KM 4th & 13th to 14th. FORMATION HAS BEEN WASHED OUT. However, machine has been mobilized for clearance.... Restoration work is needed for complete clearance of traffic.

9. Namchi to Manpur fatak is Open.

10. Kholaghari to Jaubari road is Open.

Jorethang Sub-division

1.Melli approach road open

2.Melli Kherabari Turuk Sadam Bhanjyang open

3.Melli payong open

4.Melli Suntaley Sadam open

5.Melli Passi katyang Namthang open

6.Melli Phongla open

7.Manpur NH to Sumbuk Lunchok open

8.Jorethang station rd open

9.Ccct fatak to Shalgari fatak to Assangethang open

10.3rd mile Golai to Harrabotey open

11.Denchung Dong to Harrabotey open

12.Sikkip vok open

13.Vok omchu open

14.Vok Umrangfalls open

15.All FWR block due to minor n major slide .

Roads under ABD

1.Jorethang to Manpur road open Sk01.

2.Jorethang to Namchi road open upto 15km road has diverted from 9mile via helipad sk02.

Yangang Sub-division

1.Yangang Makha Tanak Road is Open but due to shooting Boulders at Lapshi dara Km 10 Ch 5,6,traffic diverted through Mangzing Diversion Road.

2.Ben Thalabari to Manglay road is Open for Light Vehicles only due to the Formation Washout and Major Slide at Multiple stretches.
Machine and manpower engaged for Clearance and maintenance.

3.Gagyong Kasel Dara to Manglee Road is Blocked due to formation sunkdown and Slide at Km 4 Ch 6,7.
Machine and manpower will be engaged for Clearance and maintenance.

4.Some of the FWR are blocked due to major and minor slips.

Daramdin Sub-division

1.NDP Road open.

2.Soreng Sombarey road open via M/Rumbuk Kholatar.

3.Sombarey Hilley Ribdi Bhareng open.

4.Sombarey Piuraytar open for LMV only.

5.Other ODRs are open as of now except FWRs.

Kaluk Sub-division

1.1.Bermiok-Legship blocked at GHUNGRUNGAY km-8.Has a diversion to ply via Chokti Golai.
And also @ km 12 due to sunk down and road formation washed out.

2.Rest all clear except few of the FWRs with major & minor slips.

Rabong Sub-division

1.All roads under rabong sub division are open except the fair weather roads.

Gyalshing Sub-Division

1.Rimbi-Khechuperi road open

2.Pelling-Rimbi road open

3.Rimbi-Yaksam road open

4.Yaksam- Tashiding road closed due to increased in water level and damaged of Formation.

5.Tashiding-Rangit road open

6.Chongrang-Labdang road open

7.Legship-Gyalshing road open

8.Gyalshing-Pelling road open

9.Gyalshing-Sakyong road open.

10.Darap-Nambu road open.

11.Darap - Syangkhola road is closed.

Most of the FWRs are closed.

Note:
**Along Yaksam -Tashiding road abutment construction work under progress for laying Bailey Bridge .So the traffic is diverted via Nessa.

Sub-Division-IV

1.All roads clear for vehicular movement.

National Highway Wing

1.NH-710(melli manpur namchi road), is open for traffic.

2.NH-710(tarku damthang namchi road) is open and clear.

3.Nayabazar legship road is open for traffic

4.NH-310A(tashi view point to mangan road) is open and clear.



Date: 13 September-2021 (06:29 AM)

Road sitrep- 13/09/2021

Pakyong Sub-Division

1.Assam pakyong road closed at km 8th ch2nd to ch 5th due to massive slide occurred on 21st August. 150m length of road washed out . Joint inspection with L&R DEPTT , public, panchayat, & MLA done on 7th September 2021 and it was decided to start the restoration works after 20th September 2021 when the monsoon subside .

2.Other roads are open.

Singtam Sub-Division

1.All roads under singtam sub division is clear and open for traffic except FWroad.

Mangan Sub-Division

1.Phidang Sangtok road blocked.

2.All other roads open except FWRs.

Soreng Sub-division

1.Soreng kaluk road at Km 10th is trafficable for LMV only .

2.Rest all roads are trafficable for all types of vehicular movement

3.All FWRs are blocked due to slips

Namchi Sub-divison.

1. Namchi-phongla-Mamring road is Open for all types of vehicle. One way traffic is only possible at few of the locations, due to slip

2. Namchi to Vok is Open for LMV only.

3. Namchi to Rong-Sumbuk is Open.

4. Namchi to CCCT fatak via Assangthang is Open.

5. Namchi to Perbing via Upper Ghurpisey is Open.

6. Namchi Byepass road is Open for LMV only.

7. Phongla to Chuba Perbing road is Open for LMV only.

8. Phongla to Bermiok road is blocked at KM 4th & 13th to 14th. FORMATION HAS BEEN WASHED OUT. However, machine has been mobilized for clearance.... Restoration work is needed for complete clearance of traffic.

9. Namchi to Manpur fatak is Open.

10. Kholaghari to Jaubari road is Open.

Jorethang Sub-division

1.Melli approach road open

2.Melli Kherabari Turuk Sadam Bhanjyang open

3.Melli payong open

4.Melli Suntaley Sadam open

5.Melli Passi katyang Namthang open

6.Melli Phongla open

7.Manpur NH to Sumbuk Lunchok open

8.Jorethang station rd open

9.Ccct fatak to Shalgari fatak to Assangethang open

10.3rd mile Golai to Harrabotey open

11.Denchung Dong to Harrabotey open

12 Sikkip vok open

13.Vok omchu open

14.Vok Umrangfalls open

15.All FWR block due to minor n major slide .

Roads under ABD

1.Jorethang to Manpur road open Sk01.

2.Jorethang to Namchi road open upto 15km road has diverted from 9mile via helipad sk02.

Yangang Sub-division

1.Ravangla Yangang Road is Open for down coming vehicles only due to the Road formation sunkdown at Km 7 Ch 33(Lower Dozak).
Machine and Manpower engaged for Clearnce and maintenance.

2.Yangang Makha Tanak Road is Open but due to shooting Boulders at Lapshi dara Km 10 Ch 5,6,traffic diverted through Mangzing Diversion Road.

3.Ben Thalabari to Manglay road is Open for Light Vehicles only due to the Formation Washout and Major Slide at Multiple stretches.
Machine and manpower engaged for Clearance and maintenance.

4.Gagyong Kasel Dara to Manglee Road is Blocked due to formation sunkdown and Slide at Km 4 Ch 6,7.
Machine and manpower will be engaged for Clearance and maintenance.

5.Some of the FWR are blocked due to major and minor slips.

Daramdin Sub-division

1.NDP Road open.

2.Soreng Sombarey road open via M/Rumbuk Kholatar.

3. Sombarey Hilley Ribdi Bhareng open.

4.Sombarey Piuraytar open for LMV only.

5.Other ODRs are open as of now except FWRs.

Kaluk Sub-division

1.Bermiok-Legship blocked at GHUNGRUNGAY km 8.Has a diversion to ply(under the supervision of Dept)& also at Km 12(Project road/work)due to sunk down and washed out in the road formation.Machine will be engaged today onwards at the stretches of Km 12 to makesure the road gets clear/open for atleast LMV.

2.Rest all clear except few of the FWRs.

Rabong Sub-division

1.All roads under rabong sub division are open except the fair weather roads.

Gyalshing Sub-Division

1.Rimbi-Khechuperi road open

2.Pelling-Rimbi road open

3.Rimbi-Yaksam road open

4.Yaksam- Tashiding road closed due to increased in water level and damaged of Formation.

5.Tashiding-Rangit road open

6.Chongrang-Labdang road open

7.Legship-Gyalshing road open

8.Gyalshing-Pelling road open

9.Gyalshing-Sakyong road open.

10.Darap-Nambu road open.

11.Darap - Syangkhola road is closed.

Most of the FWRs are closed.

Note:
**Along Yaksam -Tashiding road abutment construction work under progress for laying Bailey Bridge .So the traffic is diverted via Nessa.

Sub-Division-IV

1.All roads clear for vehicular movement.

National Highway Wing

1.NH-710(melli manpur namchi road), is open for traffic.

2.NH-710(tarku damthang namchi road) is open and clear.

3.Nayabazar legship road is open as of now

4.NH-310A(tashi view point to mangan road) is open and clear.



Date: 08 September-2021 (05:48 AM)

Road sitrep- 08/09/2021

Pakyong Sub-Division

1.Assam pakyong road closed at km 8th ch2nd to ch 5th due to massive slide occurred on 21st August. 150m length of road washed out . Joint inspection with L&R DEPTT , public, panchayat, & MLA done on 7th September 2021 and it was decided to start the restoration works after 20th September 2021 when the monsoon subside .

2.Other roads are open.

Singtam Sub-Division

1.All roads under singtam sub division is clear and open for traffic except FWroad.

Mangan Sub-Division

1.Phidang Sangtok road blocked.

2.All other roads open except FWRs.

Soreng Sub-division

1.Due to control flow of boulders and slips soreng kaluk road km 10th has become narrow and it is trafficable for LMV only. Heavy vehicles are not allowed and diverted via kaluk Rinchenpong and sreebadam Deythang Mangalbaria .

2.Rest all roads are trafficable except FWRS which are blocked due to slips

Namchi Sub-divison.

1. Namchi-phongla-Mamring road is Open for all types of vehicle. One way traffic is only possible at few of the locations, due to slip

2. Namchi to Vok is Open for LMV only.

3. Namchi to Rong-Sumbuk is Open.

4. Namchi to CCCT fatak via Assangthang is Open.

5. Namchi to Perbing via Upper Ghurpisey is Open.

6. Namchi Byepass road is Open for LMV only.

7. Phongla to Chuba Perbing road is Open for LMV only.

8. Phongla to Bermiok road is blocked at KM 4th & 13th to 14th. FORMATION HAS BEEN WASHED OUT. However, km 4th has been made trafficable for LMV only.

9. Namchi to Manpur fatak is Open.

10. Kholaghari to Jaubari road is Open.

Jorethang Sub-division

1.Melli approch road open

2.Melli Kherabari Turuk Sadam Bhanjyang open

3.Melli Passi katyang Namthang open

4.Melli payong open

5.Melli Suntaley open

6.Manpur Sumbuk Lunchok open

7.Jorethang station road open

8.Ccct Fatak to Shalgari open

9.3rd mile Golai to Harrabotey open

10.Denchung to Dong Harrabotey open

11.Sikkip Vok road Open.

12.Vok to Umrangfalls open

13.Vok to omchu block at km 2 due to private land owner not allowed to put machine .

14.All FWR Block due to minor n major landslide

Roads under ABD

1.Jorethang to Namchi road open upto 15km road has diverted from 9mile via helipad Sk02.

2.Jorethang to Manpur road open Sk01.

Yangang Sub-division

1.Ravangla Yangang Road is Open for down coming vehicles only due to the Road formation sunkdown at Km 7 Ch 33(Lower Dozak).
Machine and Manpower engaged for Clearnce and maintenance.

2.Bermoik Phongla Road is blocked at Km 2 Ch 1 due to Slip.
Machine and manpower engaged for Clearance and maintenance.

3.PSY Road is Open for Light Vehicles only due to the formation Washout, major flash Flood and major slides at Multiple stretches.
Machine and manpower engaged for Clearance and maintenance.

4.Yangang Makha Tanak road is blocked at Lapshi Dara Km 10 Ch 5,6 due to the Major slide.
Machine and manpower engaged for Clearance and maintenance.

5.Ben Thalabari to Manglay road is Open for Light Vehicles only due to the Formation Washout and Major Slide at Multiple stretches.
Machine and manpower engaged for Clearance and maintenance.

6.Some of the FWR are blocked due to major and minor slips.

Daramdin Sub-division

1.NDP road closed at Bojeck slide area and mechine is engaging to clear all slip and slush if weather is remain clear road will be trafficable for LMV form tomorrow. Other stretches are open.

2.Soreng Sombarey road open via M/Rumbuk Kholatar road.

3.Sombarey Hilley Ribdi Bhareng open.

4.Sombarey Piuraytar road open for LMV only.

5.Other ODRs are open as of now except FWRs.

Kaluk Sub-division

1.All the roads are clear as of now except Bermiok-legship @ GHUNGRUNGAY km 8 due to washed out in the road formation and in the PROJECT WORK along the same road (km 10 onwards till 17km at stretches due to sunk down in the road formation ,formation washout & major slips at numerous stretches.

Till 9th Km there is a diversion for the commuters to ply through CHOKTI GOLAI as GHUNGRUNGAY is blocked.

Rabong Sub-division

1.All roads under rabong sub division are open except the fair weather roads.

Gyalshing Sub-Division

1.Rimbi-Khechuperi road open

2.Pelling-Rimbi road open

3.Rimbi-Yaksam road open

4.Yaksam- Tashiding road closed due to increased in water level and damaged of Formation.

5.Tashiding-Rangit road open

6.Chongrang-Labdang road open

7.Legship-Gyalshing road open

8.Gyalshing-Pelling road open

9.Gyalshing-Sakyong road closed

10.Darap-Nambu road open.

11.Darap - Syangkhola road is closed.

12.Most of the FWRs are closed.

Note:
**Along Yaksam -Tashiding road abutment construction work under progress for laying Bailey Bridge .So the traffic is diverted via Nessa.

**Along Darap - Singkhola road Machine has been engaged

Sub-Division-IV

1.All roads clear for vehicular movement.

National Highway Wing

1.NH-710(melli manpur namchi road), is open for traffic.

2.NH-710(tarku damthang namchi road) is open and clear.

3.Nayabazar legship road is open for traffic

4.NH-310A(tashi view point to mangan road) is open and clear.



Date: 06 September-2021 (06:08 AM)

Road sitrep- 06/09/2021

Pakyong Sub-Division

1.Assam pakyong road closed at km 8th ch2nd to ch 5th due to massive slide occurred on 21st August. 150m length of road washed out . Will start restoration work soon.

2.Lall Turning basilakha road open .

3.Other roads are open.

Singtam Sub-Division

1.All roads under Singtam sub division is clear and open for traffic except FW road with minor slips and blocked drains in various stretches.

Mangan Sub-Division

1.Phidang Sangtok road blocked.

2.All other roads open except FWRs.

Soreng Sub-division

1.All roads are trafficable except FWRS which are blocked due to major and minor slips.

Namchi Sub-divison.

1. Namchi-phongla-Mamring road is Open for all types of vehicle.

2. Namchi to Vok is Open for LMV only.

3. Namchi to Rong-Sumbuk is Open.

4. Namchi to CCCT fatak via Assangthang is Open.

5. Namchi to Perbing via Upper Ghurpisey is Open.

6. Namchi Byepass road is Open for LMV only.

7. Phongla to Chuba Perbing road is Open for LMV only.

8. Phongla to Bermiok road is blocked at KM 4th & 13th to 14th. FORMATION HAS BEEN WASHED OUT. However, km 4th has been made trafficable for LMV only.

9. Namchi to Manpur fatak is Open.

10. Kholaghari to Jaubari road is Open.

Jorethang Sub-division

1.Melli approch road open

2.Melli Kherabari Turuk Sadam Bhanjyang open

3.Melli Passi katyang Namthang open

4.Melli payong open

5.Melli Suntaley open

6.Manpur Sumbuk Lunchok open

7.Jorethang station road open

8.Ccct Fatak to Shalgari open

9.3rd mile Golai to Harrabotey open

10.Denchung to Dong Harrabotey open

11.Sikkip Vok road Open.

12.Vok to Umrangfalls open

13.Vok to omchu block at km 2 due to private land owner not allowed to put machine .

14.All FWR Block due to minor n major landslide

Roads under ABD

1.Jorethang to Manpur road block at 19km Sk01.

2.Jorethang to Namchi road open upto 15km road has diverted from 9mile via helipad Assanthang sk02.

Yangang Sub-division

1.Ravangla Yangang Road is Blocked due to the Road formation sunkdown at Km 7 Ch 33(Lower Dozak) and Flash Flood occurred at Gogune Km 10 Ch 18.
Machine and Manpower will be engaged for Clearnce and maintenance.

2.Bermoik Phongla Road is blocked at Km 2 Ch 1 due to Slip.
Machine and manpower will be engaged for Clearance and maintenance.

3.PSY Road is Open for Light Vehicles only due to the formation Washout, major flash Flood and major slides at Multiple stretches.
Machine and manpower engaged for Clearance and maintenance.

4.Yangang Makha Tanak road is blocked at Lapshi Dara Km 10 Ch 5,6 due to the Major slide.
Machine and manpower engaged for Clearance and maintenance.

5.Ben Thalabari to Manglay road is Open for Light Vehicles only due to the Formation Washout and Major Slide at Multiple stretches.
Machine and manpower engaged for Clearance and maintenance.

6.Some of the FWR are blocked due to major and minor slips.

Daramdin Sub-division

1.NDP road closed at Bojeck slide area rest of the stretches are open.

2.Soreng Sombarey road open via Middle Rumbuk Kholatar road.

3.Sombarey Hilley Ribdi Bhareng open.

4.Sombarey Piuraytar open for LMV only.

5.other ODRs are open except FWRs.

Kaluk Sub-division

1.Bermiok-legship blocked at GHUNGRUNGAY due to wash out in the road formation of around 2chain.Has a diversion to ply.

2.Singshore Diversion blocked along Dentam-Uttarey .Contractor been instructed to clear the slip at earliest.

3.Rest all clear except few of the FWRs.

Rabong Sub-division

1.Road blocked at km 2nd ghundrukay along legship tashiding road men and machineries shall be deployed ASAP.

2.Fair weather roads are blocked due to major and minor slides..

3.Rest of the roads under Rabong Sub Division are open as of now...

Gyalshing Sub-Division

1.Rimbi-Khechuperi road open

2.Pelling-Rimbi road open

3.Rimbi-Yaksam road open

4.Yaksam- Tashiding road closed due to increased in water level and damaged of Formation.

5.Tashiding-Rangit road open

6.Chongrang-Labdang road open

7.Legship-Gyalshing road open

8.Gyalshing-Pelling road open

9.Gyalshing-Sakyong road closed

10.Darap-Nambu road open.

11.Darap - Syangkhola road is closed.

12.Most of the FWRs are closed.

Note:

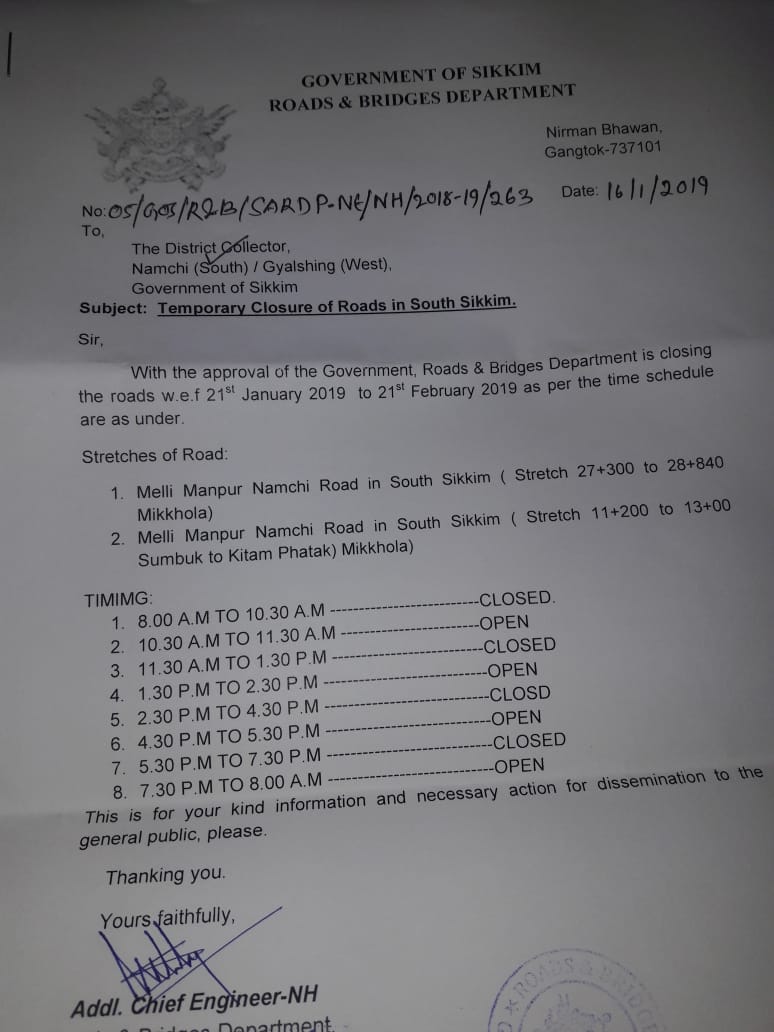

**Along Yaksam -Tashiding road abutment construction work under progress for laying Bailey Bridge .So the traffic is diverted via Nessa.

**Along Darap - Singkhola road Machine has been engaged

Sub-Division-IV

1.GRS road partially open at km 15th ch 22 nd (pagla bhir stretch) with active slip and machinery on standby.

2.Rest all roads clear for vehicular movement.

National Highway Wing

1.NH-710(melli manpur namchi road), is blocked at KM 8+300(lambha vhir), machine has been mobilised for clearance

2.NH-710(tarku damthang namchi road) is open and clear.

3.Nayabazar legship road is open for traffic

4.NH-310A(tashi view point to mangan road) is clear.

5.NH-10(9th mile bypass road is open and clear)



Date: 02 September-2021 (06:41 AM)

Road sitrep- 02/09/2021

Pakyong Sub-Division

1.Assam pakyong road closed at km 8th ch2nd to ch 5th due to massive slide occurred on 21st August. 150m length of road washed out. Joint inspection with Land revenue Deptt done .Slide is still active.

2.Lall Turning basilakha road closed at km 2nd due to major slide on 20th August. Men and machine engaged for clearance and restoration work. Likely to open tomorrow.

3.Other roads are open.

Singtam Sub-Division

1.All roads under singtam sub division is clear and open for traffic except FW road with minor slips and blocked drains in various stretches.

2.Road blocked at sangkhola zingla Martam at km6 ch3.

Mangan Sub-Division

1.Phidang Sangtok road blocked.

2.All other roads open except FWRs.

Soreng Sub-division

1.Soreng kaluk road is blocked at km 10th due to slips. Machine will be engage for clearance at the earliest.

2.Budang Chumbong road blocked at km 5th

3.Rest all roads are trafficable except FWRS

Namchi Sub-divison.

1.Namchi-phongla-Mamring road is blocked as of now at two major points.
a.VIEW POINT... KM 4TH.

b.NEAR Narak Jhora... km 36th.

c.Blocked at Rabi khola at km 10th.

d.Major slip at Dabua,Near Narak Jhora.
Machine has been mobilized for clearance.

2. Namchi to Vok -Sikkip blocked at Kolok Jhora.

3. Namchi to Rong-Sumbuk is Open.

4. Namchi to CCCT fatak via Assangthang is Open.

5. Namchi to Perbing via Upper Ghurpisey is Open.

6. Namchi Byepass road is Open for LMV only.

7. Phongla to Chuba Perbing road is Open for LMV only.

8. Phongla to Bermiok road is blocked, formation has been washed out at KM 13th.

9. Namchi to Manpur fatak is blocked at Bird Sanctuary area

10.Kholaghari to Jaubari road is Open.

Jorethang Sub-division

1. Melli approach road open for LMV

2. Melli Phongla open

3. Melli Kherabari Turuk Sadam Bhanjyang open

4. Melli Passi katyang to Namthang open

5. Manpur NH to Sumbuk Lunchok open

6. Jorethang station road open

7. Melli Suntaley Sadam open

8. CCCT Fatak to Shalgari open

9. Denchung Dong Harrabotey open

10. 3rd mile Golai to Harrabotey open

11. Sikkip to Vok open

12. Vok to omchu block

13. Vok to Umrangfalls upper Omchu block at km 5 Rabung khola

14 .All FWR block due to major n minor slips .

Roads under ABD

1.Jorethang to manpur road block machine has been deploy for clerance sk01.

2.Jorethang to Namchi road Joerthang to Namchi road block at 8mile 10km due to the continous rainfall machine will deploy as soon as possible road has taken diversion from CCCT fatak via assathang Namchi.

Yangang Sub-division

1.Ravangla Yangang Road is Blocked due to the Road formation sunkdown at Km 7 Ch 33(Lower Dozak),Immediate traffic clearance is under progress.
Machine and Manpower engaged for Clearnce and maintenance.

2.Some of the FWR are blocked due to major and minor slips.

3. Rest all of the roads are open as of now.

Daramdin Sub-division

1.NDP road closed at Bojeck slide area.At box cutting below Daramdin bazar temporary road open and rest of the stretches are open for all traffic.

2.Soreng Sombarey road closed near Gaythang khola diversion road form M/Rumbuk to Moonew via Kholatar is open.

3.Sombarey Hilley pen.

4.Sombarey Piuraytar open for LMV ony.

5.Other ODRs are open as of now except FWRs.

Kaluk Sub-division

1.Bermiok-Legship blocked at GHUNGRUNGAY due to wash out in the road formation but has a diversion to ply.

2.Rest all clear as of now except few of the FWRs.

Rabong Sub-division

1.Road blocked at km 2nd ghundrukay along legship tashiding road men and machineries shall be deployed ASAP.

2.Fair weather roads are blocked due to major and minor slides.

3.Rest of the roads under Rabong Sub Division are open as of now.

Gyalshing Sub-Division

1.Rimbi-Khechuperi road open

2.Pelling-Rimbi road open

3.Rimbi-Yaksam road open

4.Yaksam- Tashiding road closed due to increased in water level and damaged of Formation.

5.Tashiding-Rangit road open

6.Chongrang-Labdang road open

7.Legship-Gyalshing road open

8.Gyalshing-Pelling road open

9.Gyalshing-Sakyong road open

10.Darap-Nambu road open.

11.Darap - Syangkhola road is closed.

12.Most of the FWRs are closed.

Note:
**Along Yaksam -Tashiding road abutment construction work under progress for laying Bailey Bridge .So the traffic is diverted via Nessa.

**Along Darap - Singkhola road Machine has been engaged

Sub-Division-IV

1.GRS road partially open at km 15th ch 22 nd (pagla bhir stretch) with active slip and machinery on standby.

2.Rest all roads clear for vehicular movement.

National Highway Wing

1.NH-710(melli manpur namchi road), is blocked at KM 3+100(pucca pool), KM 5+700(aap khola), KM 8+300(lambha bhir) and KM 15+500(bird sanctuary). Machine has been mobilised for clearance.

2.NH-710(tarku damthang namchi road) is open and clear.

3.Nayabazar legship road is blocked at various stretches

4.NH-310A(tashi view point to mangan road) is open and clear.

5.NH-10(9th mile bypass road is open and clear)



Date: 31 August-2021 (06:11 AM)

Road sitrep- 31/08/2021

Pakyong Sub-Division

1.Assam pakyong road closed at km 8th ch2nd to ch 5th due to massive slide occurred on 21st August. 150m length of road washed out. Joint inspection with Land revenue Deptt done .Slide is still active.

2.Lall Turning basilakha road closed at km 2nd due to major slide on 20th August. Men and machine engaged for clearance and restoration work.

3.Other roads are open.

Singtam Sub-Division

1.All roads under singtam sub division is clear and open for traffic except FW road.

Mangan Sub-Division

1.Phidang Sangtok road blocked.

2.All other roads open except FWRs.

Soreng Sub-division

1.Soreng kaluk road is trafficable as of for LMV only . Machine will engage again to clear all the slips to make the road trafficable for all types of vehicular movement

2.Road formation damage along Soreng Beechgoan road km 2nd .road is trafficable for LMV only.

3.Rest all roads are trafficable except FWRS

Namchi Sub-divison.

1. Namchi-phongla-Mamring road is Open. However, road is sinking vertically around Narak Jhora side, so careful driving is a must.

2. Namchi to Vok is Open for LMV only.

3. Namchi to Rong-Sumbuk is Open.

4. Namchi to CCCT fatak via Assangthang is Open.

5. Namchi to Perbing via Upper Ghurpisey is Open.

6. Namchi Byepass road is Open for LMV only.

7. Phongla to Chuba Perbing road is Open for LMV only.

8. Phongla to Bermiok road is blocked, formation has been washed out at KM 13th.

9. Namchi to Manpur fatak is blocked at Bird Sanctuary area

10. Kholaghari to Jaubari road is Open.

Jorethang Sub-division

1.Melli approch road block ,restoration work under progress.

2.Melli Kherabari Turuk Sadam Bhanjyang open

3.Melli Suntaley Sadam open

4.Passi katyang Namthang open

5.Melli Phongla open

6.Manpur NH to Sumbuk Lunchok open

7.Jorethang station road open

8 Ccct fatak to Shalgari open

9.Denchung to Dong Harrabotey open

10.3rd mile Golai to Harrabotey open
Sikkip to Vok open

11.Vok to omchu block

12 Vok to Umrangfalls open

13.Most of FWR Block due to multiple major n minor landslide .

Roads under ABD

1.Jorethang to Manpur road open Sk01.

2.Jorethang to Namchi road open upto 15km road has taken diversion from 9mile via assanthang helipad Sk02.

Yangang Sub-division

1.Ravangla Yangang Road is Blocked due to the Road formation sunkdown at Km 7 Ch 33(Lower Dozak),Immediate traffic clearance is under progress.
Machine and Manpower engaged for Clearnce and maintenance.

2.Some of the FWR are blocked due to major and minor slips.

3. Rest all of the roads are open as of now.

Daramdin Sub-division

1.NDP road closed at Bojeck and below Daramdin bazar km 19 ch 20 rest of the stretches are open.

2.Soreng Sombarey road closed near Gaythang Khola diversion road from M/Rumbuk to Moonew open.

3.Sombarey Hilley open.

4.Sombarey Piuraytar open for LMV only

5.Anden Tareybhir open for LMV only

6.Other ODRs are open as of now except FWRs.

Kaluk Sub-division

1.Bermiok-Legship blocked at GHUNGRUNGAY due to wash out in the road formation but has a diversion to ply.

2.Rest all clear as of now except few of the FWRs.

Rabong Sub-division

1.All roads under rabong sub division are open except the fair weather roads.

Gyalshing Sub-Division

1.Rimbi-Khechuperi road open

2.Pelling-Rimbi road open

3.Rimbi-Yaksam road open

4.Yaksam- Tashiding road closed due to increased in water level and damaged of Formation.

5.Tashiding-Rangit road open

6.Chongrang-Labdang road open

7.Legship-Gyalshing road open

8.Gyalshing-Pelling road open

9.Gyalshing-Sakyong road closed .

10.Darap-Nambu road open.

11.Darap - Syangkhola road is closed.

12.Most of the FWRs are closed.

Note:
**Along Yaksam -Tashiding road abutment construction work under progress for laying Bailey Bridge .So the traffic is diverted via Nessa.

**Along Darap - Singyang road Machine has been already engaged.

**Along Gyalshing - Sakyong road at Km 0 to 1 ,machine has been engaged .

Sub-Division-IV

1.GRS road partially open at km 15th ch 22 nd (pagla bhir stretch) with active slip and machinery on standby.

2.Rest all roads clear for vehicular movement.

National Highway Wing

1.NH-710(melli manpur namchi road), is blocked at KM 14+100(bird sanctuary). Machine has been mobilised for clearance.

2.NH-710(tarku damthang namchi road) is open and clear.

3.Nayabazar legship road is open and clear

4.NH-310A(tashi view point to mangan road) is open and clear

5.NH-10(9th mile bypass road) is open and clear



Date: 19 August-2021 (06.52 AM)

Road sitrep- 19/08/2021

Pakyong Sub-Division

1.All roads are open for traffic.

Singtam Sub-Division

1.All roads under Singtam sub division is clear and open for traffic except FWR.

Mangan Sub-Division

1.Phidang Sangtok road blocked.

2.Rest all roads open except FWRs.

Soreng Sub-division

1.Soreng kaluk road is open despite of damage in formation at km 11th, restoration work has started after verbal approval from ACE (S/W). But more cracks has formed on the road surface at different stretches along this road.

2.Nayabazar Soreng road is open .here also few cracks on the road surface had formed.

3.Rest all roads are trafficable despite of several slips.

4.All FWRs are blocked

Namchi Sub-divison.

1. Namchi-Phongla-Mamring road is Open for all types of vehicle.

2. Namchi to Vok is Open for LMV only.

3. Namchi to Rong-Sumbuk is Open.

4. Namchi to CCCT fatak via Assangthang is Open.

5. Namchi to Perbing via Upper Ghurpisey is Open.

6. Namchi Byepass road is Open for LMV only.

7. Phongla to Chuba Perbing road is Open for LMV only.

8. Phongla to Bermiok road is blocked., however machine being mobilized for clearance.

9. Namchi to Manpur fatak is blocked at kitam Bird Sanctuary area.

10. Kholaghari to Jaubari road is Open.

Jorethang Sub-division

1. Melli Bazaar approach road block.

2. Melli Phongla open

3. Melli Kherabari Turuk Sadam Bhanjyang open

4. Melli payong open

5. Melli Suntaley Sadam open

6. Passi katyang to Namthang block at km 3rd Kali khola

7. Manpur Sumbuk Lunchok open

8 .Ccct to Shalgari open

9. Sikkip to Vok open

10.Vok to Umrangfalls open

11.Vok to omchu block

Roads under ABD

1.Jorethang to Manpur road block at various location SK01.

2.Jorethang to Namchi road block Sk02.

Yangang Sub-division

1.Ravangla Yangang Road is Blocked due to the Road formation sunkdown at Km 7 Ch 33(Lower Dozak).
Machine and Manpower will be engaged for maintenance.

2.Some of the FWR are blocked due to major and minor slips.

3. Rest all of the roads are open as of now.

Daramdin Sub-division

1.NDP road closed at Bojeck due to sunk down of road formation day by day and it is not possible to restore right now.Restoration work will be done after weather is clear. Rest of the other stretches are open.

2.Sombarey Pueraytar road open for light vehicle only.

3.Soreng Sombarey road formation also sunk down at near Gaythang Khola filling work of sundown portion is continuously provided but process of sundown is still active however road is trafficable for all vehicle.

3.Sombarey Hilley road open.

4.Anden Tareybhir road open for LMV.

5.Rest of the ODRs are open as of now except FWRs.

Kaluk Sub-division

1.Bermiok-Legship road blocked at GHUNGRUNGAY km 8 due to washout in the formation at large stretch but has a diversion to ply which is CHOKTI-GOLAI to Legship and further for LMVs only.

2.Rest all the roads are clear as of now except few of the FWRs with major & minor slips.

Rabong Sub-division

1.Road blocked at km 2nd ghundrukay along legship tashiding road men and machineries shall be deployed ASAP..

2.Road blocked at km 1st along link road to Maltini due to formation washout.

3.Fair weather roads are blocked due to major and minor slides.
Rest of the roads under Rabong Sub Division are open as of now.

Gyalshing Sub-Division

1.Rimbi-Khechuperi road open

2.Pelling-Rimbi road open

3.Rimbi-Yaksam road open

4.Yuksam- Tashiding road closed due to increased in water level and damaged of Formation.

5.Tashiding-Rangit road open

6.Chongrang-Labdang road open

7.Legship-Gyalshing road open

8.Gyalshing-Pelling road open

9.Gyalshing-Sakyong road Open.

10.Darap-Nambu road open.

11.Most of the FWRs are closed.

Sub-Division-IV

1.All roads clear for vehicular movement.

National Highway Wing

1.NH-710(melli manpur namchi road) is open for traffic.

2.NH-710(tarku damthang namchi road) is open and clear.

3.Nayabazar legship road-road blocked at Rungdung.

4.NH-310A(tashi view point to mangan road) is open and clear.

5.NH-10(9th mile bypass road) is open and clear.



Date: 29 July-2021 (06.22 AM)

Road sitrep- 29/07/2021

Pakyong Sub-Division

1 All roads are open and clear except Bandey Pokrel Marg which is Closed. Restoration work under progress.

2.Kingstone-Maney Dara temporary diversion has been done.

3.Rorathang-Rongli road Open with minor and major slips.

4.All FWR roads are closed.

Singtam Sub-Division

1.Radang kimchithang road blocked at km1.

2.Rest all roads open and clear for traffic .

Mangan Sub-Division

1.Clearance works under progress along Bop village road.

2.Phidang Sangtok blocked due to slides along km2 machine to be engaged.

3.Rest all roads open except most FWRs due to minor slides

Soreng Sub-division

1.All roads under soreng sub division are trafficable except FWRS.

Namchi Sub-divison.

1.Namchi-Phongla-Mamring road is Open

2.Namchi to Vok-Sikkip is Open

3.Namchi -Rong-Sumbuk road is Open.

4.Namchi to CCCT fatak via Assangthang is Open

5.Kholaghari to Jaubari is Open

6.Chuba-Perbing road is Open

7.Namachi Ghurpisey-Perbing road is Open

8.Namchi to Manpur road is Open

9. Phongla to Bermiok is blocked at Km13th, machine is at work, may take one more day to clear.

10.Namchi Byepass road is Open for LMV only

Jorethang Sub-division

1.Melli Kherabari Turuk Sadam Bhanjyang open

2.Melli Suntaley Sumbuk open

3.Melli Payong open

4.Melli Phongla open

5.Melli Passi katyang Namthang blocked at km 3rd , Khali khola slide

4.Melli bazaar Approach open only for LMV.

5.Manpur Sumbuk Lunchok open

6.Jorethang station road open

7.3rd mile Golai to Harrabotey open

8.Denchung to Dong and Harrabotey open

9.Ccct to Shalgari open

10.Sikkip to Vok open

11.Vok to omchu blocked at km 2nd.

12.Sikkip to Vok open

13.Vok to Umrangfalls blocked at km 6.

14.Melli approach road Open.

15.All FWR blocked

16.Melli Payong open for LMV.

Roads under ABD

1.Jorethang to Manpur road open SK01.

2.Jorethang to Namchi road is open SK02.

Yangang Sub-division

1.Ravangla Yangang Road is Open for Down coming vehicles only due to the Road formation sunkdown at Km 7 Ch 33(Lower Dozak).Machine and Manpower will be engaged for  maintenance.

2.Yangang Makha Road is Open for Light Vehicles only due to the Minor Slip occurred at Mangzing Slide Km 9 Ch 19.
   Manpower will be engaged for Clearance.

3.Some of the FWR are blocked due to major and minor slips.

4.Rest all of the roads are open as of now.

Daramdin Sub-division

1.All the roads under Daramdin Sub Division are open as of now except FWRs.

Kaluk Sub-division

1.Reshi-Rinchenpong road blocked at Vet.area & Tafel.Work under progress.

2.Bermiok-Legship road blocked at km -17 due to slip.Settlement between contractor & villagers seems unsatisfactory so the matter is still kept in pending.However, machine is       kept standby at the slip point.

3.Rest all the roads are clear as of now except few of the FWRs with major & minor slips.

Rabong Sub-division

1.All Fair weather roads are blocked due to major and minor slides.

2.Rest of the roads under Rabong Sub Division are open as of now.

Gyalshing Sub-Division

1.Rimbi-Khechuperi road open

2.Pelling-Rimbi road open

3.Rimbi-Yaksam road open

4.Yaksam- Tashiding road open for heavy Vehicles only.

5.Tashiding-Rangit road open

6.Chongrang-Labdang road open

7.Legship-Gyalshing road blocked at Khopa.

8.Gyalshing-Pelling road open

9. Nambu- Darap road open

10.Most of the FWRs are closed.

Sub-Division-IV

1.All roads clear for vehicular movement.

National Highway Wing

1.NH-710(melli manpur namchi road) is open for traffic.

2.NH-710(tarku damthang namchi road) is open and clear.

3.Nayabazar legship road is open as of now.

4.NH-310A(tashi view point to mangan road) is open and clear.



Date: 27-May-2021 (08.28 AM)

Road sitrep- 27/05/2021

Pakyong Sub-Division

1.All roads under pakyong subdivision are open.

Soreng Sub-division

1.All roads under soreng sub division are trafficable as of now except Rothak Segyang road.

Jorethang Sub-division

1. All roads under Jorethang SD are open as of now .

Namchi sub division

1. Phongla-Bermiok road blocked at Km 13th.

2. Namchi-Vok road blocked at Tirikhola, Silimbhir and debris accumulated at Rangrang kholsa.

3. Few other FWR are also blocked,complaints and request received for the same to clear immediately under Poklok Kamrang constituency.

Roads under ABD

1.Jorethang to Namchi road block,Road blocked at 8th 9th 12th mile at Jorethang road due to incessant rainfall.

Yangyang Sub-division

1.Minor slips has occurred in different road under Yangang sub-division due to heavy rainfall of last night. Which will be cleared by labour

2. All the road are trafficable as of now.

Daramdin Sub-division

1.All the roads under Daramdin Sub division are open.

Rabong Sub-division

1.All roads under rabong sub division are open.

Gyalshing Sub-division

1.All roads under Gyalshing sub division are open.



Date: 26-May-2021 (12.09 PM)

Sikkip Vok road was blocked at morning time is now the road is trafficable by department.

Labour's been deployed to clear all the choked drains and CD's.



Date: 12-May-2021 (03.20 PM)

Traversing of road from Kamrang fatak to Khechedumra being carried out in South Sikkim.



Date: 11-May-2021 (01.10 PM)

Ramam suspension bridge restoration work completed.

Survey work for upgradation of road from Kitchudumra to Namchi is underprogress.

Today the Division and Pakyong Sub div. have conducted a site visit to under construction Roads at Ganchung and Ganchung to Mamring



Date: 07-May-2021 (09.26 AM)

Maintainance people have been deputed for clearance of minor slips and boulders coming to roads along Phongla-Mamring road above Mamring.



Date: 04-May-2021 (10.04 AM)

Namchi to Jorethang Road block at 13km and 17km due to heavy rainfall last night.

Carpeting works along Malbasey Budang road completed today





Date: 03-May-2021 (02.57 PM)

All most ready for Raft concreting tommrow of both A1 & A2 at Kali khola 55m span steel bridge in South Sikkim.



Date: 25-April-2021 (01.35 PM)

Carpeting work along Lower Lingee to Middle Lingee Road under Yangang Sub Division.



Date: 23-April-2021 (02.23 PM)

Carpeting  works along Rong Sumbuk road is under progress.

Carpeting along Namchi Phongla road.



Date: 20-April-2021 (06.22 PM)

DGBM under progress at Salangdang along Bojeck diversion road.



Date: 19-April-2021 (06.19 PM)

Premix carpeting work at Anden Gumpa to Taraybhir road under progress.



Date: 19-April-2021 (10.33 AM)

The culvert and cross drainage constructed along Bhanjyang road.



Date: 18-April-2021 (11.06 AM)

Laying of 20mm thick premix carpeting at km-2 along Polok Hot-spring road under Rabong Sub-division in South Sikkim.



Date: 17-April-2021 (01.56 PM)

Melli Tarey bhir road block at Tarey bhir slide zone km 6th , the machine mobizing to make trafficable .



Date: 15-April-2021 (09.42 AM)

Work for carpeting of Palum Syamdas road started today after completion of all sub surface works.



Date: 13-April-2021 (11.27 AM)

Carpeting work along Zhapzapay Pakkigaon road in progress.



Date: 09-April-2021 (05.56 PM)

Wok to Umrangfalls road now trafficable for all kind of vehicle .



Date: 08-April-2021 (11.48 AM)

Laying of flexible pavement 1st layer 60mm dbm is being laid along Ralay Kambal Samdong road ,proper thickness and edge line is being maintained.



Date: 06-April-2021 (04.03 PM)

Casting of slab at Dak Banglow complex under Soreng Sub Division.



Date: 05-April-2021 (10.29 AM)

Visit of Bojeck diversion road by Secretary NEC along with CE Sir,ACE and other officers of West district.





Date: 04-April-2021 (06.49 PM)

Arrival of Secretary NEC and team along with Secretary Sir and other officials of R&B at Baiguney Resort.



Date: 03-April-2021 (04.06 PM)

Sunk down area after completion of filling work and providing and laying protective work along Magitar to Compound road in South Sikkim.





Date: 29-March-2021 (11.11 AM)

Flag hoisting ceremony in presence of Hon'ble Governor Shri Ganga Prasad and Hon'ble Chief minister Shri Prem Singh Tamang (Golay)at M.G Marg concluded.



Date: 27-March-2021 (05.56 PM)

Temporary road open at Famrong.



Date: 18-March-2021 (02.10 PM)

Carpeting started along kholaghari to Jaubari,km 8th to 12th.



A1 side erection in progress and A2 side mud cleaning Kayem 2 lane bridge in Dzongu.





Date: 17-March-2021 (10.06 AM)

Carpeting of Rong Sumbuk road in progress.



Date: 15-March-2021 (05.51 PM)

Carpeting of road in DBM is under progress along Phongla Bermiok road.



Date: 14-March-2021 (07.10 AM)

RCC culvert at Lingkhim khola along Bojeck diversion the RCC slab which is casted yesterday damaged totally due to heavy flash flood.



Date: 13-March-2021 (01.06 PM)

Visit of Dak banglow site by Hon'ble Area MLA Soreng, CE Sir (S/W), DE sir, Architecture team from Gangtok .The work is in progress.

Site inspection by CE Sir along Soreng Malbasey Budang road. Laying of BC is in progress.














 Road Network under Roads and Bridges Department
